Rosemount, MN

Serving Rosemount

Wood flooring in Rosemount, from the builder's selection table to a new floor's first two winters, with moisture readings recorded before the first board.

Lakeville Wood Flooring has installed and finished wood flooring in Rosemount for more than twenty years, and our first visit to a job here is a measurement visit rather than a sales call. We show up with a moisture meter and a hygrometer instead of a sample book. The relative humidity reading we take that day goes on the quote in writing, with the 30 to 50 percent band wood flooring is specified for printed next to it.

More of that work than you might expect starts before anyone has moved in. Streets here are framed in whole blocks at a time, which means the floor gets chosen at a builder’s selection appointment months before the boards ever reach the site. That is a different decision than picking a floor for a house you are standing in, and the things that go wrong are different too.

So this page is written around that decision: what a species and a board width commit you to, what a builder’s flooring allowance does and does not cover, and how a new floor behaves through its first two heating seasons. We would rather you meet those constraints on paper now than in February.

Thirteen thousand acres taken in 1942, and what is on them now

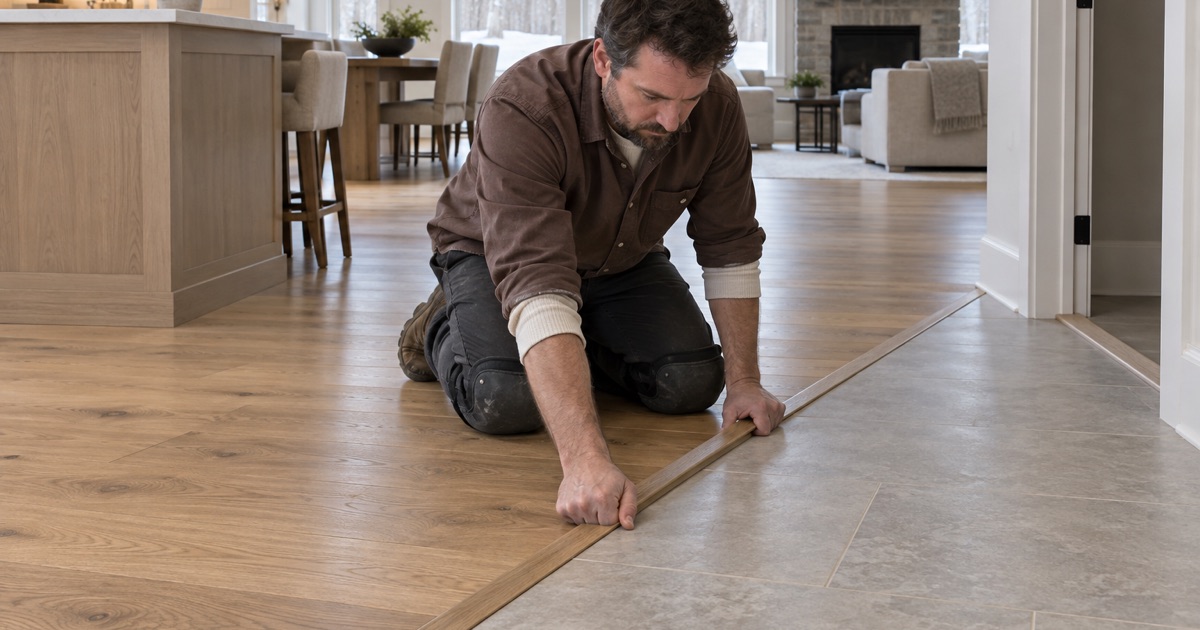

Worker setting the wood-to-tile transition in a Rosemount house of the kind going up on the city’s newest subdivision ground.

The ground under a good share of new construction in this city has an unusual paper trail. During World War II the federal government acquired 13,000 acres of Rosemount farmland, displacing 90 families in 1942, and built the Gopher Ordnance Works on it. Built by DuPont, the plant comprised 856 buildings, employed 20,000 workers and cost $124 million before operations ceased in April 1945. The University of Minnesota subsequently obtained 8,000 acres of the site, and that holding became UMore Park.

Amber Fields, and floors chosen from a plan

The Amber Fields housing subdivision is being built on 348 acres of former UMore Park land, which makes it the plainest illustration of what that history means for a floor. There is no previous house on the lot to inherit conditions from, no old subfloor, no established interior humidity, no decades of settling already done. That is an advantage and a trap at once, because nothing about the building’s moisture has reached equilibrium yet.

The City of Rosemount 2025 Economic Development Annual Report records 451 residential permits issued in 2025. We read that as permits issued and nothing else, but it does tell us something usable: at that volume, wood flooring decisions in Rosemount are being made at a builder’s table far more often than in a lived-in room. Downtown adds to the same trend, with The Morrison, a four-story 124-unit market-rate apartment building, approved in 2020, and The Landing at Amber Fields, a 160-unit affordable apartment project at the southwest corner of Akron Avenue and County Road 42.

What the housing stock says

The existing stock agrees with that picture. Half of Rosemount’s 10,175 housing units, 50.0 percent, were built in 2000 or later, the 2000s alone account for 31.2 percent as the largest single build decade, and only 3.0 percent date to 1939 or earlier. Old-house problems exist here, but they are not the ordinary condition of this city.

Housing type matters as much as age. Among owner-occupied households, 77.1 percent are in one-unit detached structures and 18.0 percent are in attached ones, while townhomes, twinhomes and rowhomes together make up 19.9 percent of all housing units. A shared wall changes the specification, because impact insulation class and sound transmission class targets belong to the floor assembly, and the underlayment that satisfies them has to be settled before the boards are ordered.

Looking for wood-flooring closer to Eagan? See Wood-Flooring Services in Eagan.

Choosing the floor before the house is closed in

A selection appointment asks you to pick a species, a width and a finish from a sample board, often before the house has drywall. Two of those three choices are easy to make and expensive to reverse, so we would rather be consulted at that table than after the trim is on.

Board width is a promise about movement

We choose board width against the species’ own dimensional change coefficient, and we state the seasonal movement to expect at that width in writing before anything is ordered. A wide plank and a two and a quarter inch strip cut from the same species do not move the same distance across a winter, because the same percentage of dimensional change acts on a wider board. Choosing wide plank is a legitimate decision; choosing it without being told what it will do in January is not.

Species carries the rest of the answer. White oak, red oak, hard maple and hickory differ both in how much they move with humidity and in how hard the surface is, which is what a Janka rating describes. Quartersawn and rift sawn material moves less across its face than plainsawn, and in a wide board that difference is usually worth what it costs.

Solid, engineered, and where the house sits in the soil

Grade is defined by the installation guidelines rather than by what a floor plan calls a level. Soil sitting within three inches of a floor puts that level below grade, so a walkout or a lookout gets quoted as what it actually is instead of as a basement or a main floor. With footings in Dakota County carried to the three and one-half foot minimum depth Minnesota Rules 1303.1600 sets for Zone II, those lower levels are deep, finished, and almost always part of the flooring conversation.

Any lower-level quote we write comes from a moisture reading taken on that slab itself, never inferred from the floor above it. On new concrete that means an in-situ relative humidity test under ASTM F2170 rather than an assumption about how long the slab has been down. A slab poured last fall is not a dry slab, and solid strip flooring laid over one is a claim waiting to be filed.

Where the reading rules out solid material, engineered flooring is the answer rather than the compromise, and the number that matters on it is the wear layer. We measure that before anyone quotes sanding, because under the sanding threshold the honest answer is replacement and not a refinish. That is a far better question to settle at a selection table than in fifteen years.

What a builder’s flooring allowance does and does not cover

A flooring allowance is a dollar figure the builder carries for your floor, written against a baseline product over a stated square footage. Upgrades in species, width, material grade or finish come out of your pocket above it, and so do stairs, transitions, and the rooms a plan quietly leaves on carpet. None of that is unfair, but it is a number that rewards reading closely.

What an allowance almost never buys is time. It pays for material and labor, not for the days a house sits with the heat running and the flooring inside it, and that unlisted item is what decides whether the floor performs. When a closing date tightens, the thing that gets compressed is the thing nobody wrote down.

Acclimation is a number, not a number of days

Acclimation in a new house is a moisture target, not a waiting period. The flooring and the subfloor are read against each other with a pin meter or a pinless meter, and the boards go down when the moisture content differential between them is inside range for the width and species being installed, not when a calendar says a week has passed. Both numbers are recorded before the first board is fastened, and both are handed to you.

That target is harder to hit in a new house than in an old one, because the building is still drying. Framing lumber, concrete and drywall compound all release water into the interior through the first heating season, and flooring that equilibrates to that inflated humidity is matching a condition which will not last. The house has to be at service conditions, with heat on and the HVAC running near the humidity it will actually hold, before an equilibrium moisture content reading means anything.

Permits and who signs off

Finish work is exempt from building permit under Minnesota Rules 1300.0120, subpart 4, item A, sub-item (8), and that exemption does not authorize work in violation of the code or any other ordinance. In a house still under construction the flooring falls inside the builder’s permit in any case, and the Minnesota State Building Code is administered here by the City of Rosemount, within Dakota County. We work to the NWFA installation guidelines whichever permit the job sits under, because that is the document a manufacturer’s warranty is written against.

A new floor’s first two winters

The first two heating seasons are the widest swing a floor here will ever take, and a new house widens them further. We explain that conflict before the work is booked rather than after the gaps appear. It is a much easier conversation in October than in January.

On a deep cold snap, the relative humidity a house here can safely hold sits below the bottom of the 30 to 50 percent band the floor is specified for. Hold the interior at the floor’s number in that weather and you get condensation on the windows and moisture in the wall assembly; hold it where the building is safe and the floor is drier than its specification. The conflict is physical rather than a maintenance failure, and hearing about it for the first time in February is what makes a customer feel misled.

What you will actually see

Seasonal gapping between boards through the cold months is the normal, expected result, and on a wide plank it is a wider line. Dry cupping, where board edges sit low because the underside holds more moisture than the face, can show up in a first winter and close again by May. Ticking and popping as the heat cycles are the sound of wood moving against fasteners rather than a defect in themselves.

What is not normal is a floor that keeps moving one direction: crowning that never relaxes, gaps that do not close over summer, or compression set, where boards crushed against each other while swollen leave permanent gaps once they shrink back. Each of those traces to a moisture decision made before installation, which is why the numbers get recorded in the first place.

Getting through it

A whole-house humidifier tied to the furnace is the usual instrument, and it does the job when it is run against a hygrometer instead of a dial setting. We would rather set a realistic winter floor for the humidity, accept some gapping, and protect the wall assembly than chase a specification the weather will not allow. That expectation goes on the quote, not into a conversation after the fact.

The rest of what we hand over is written for the same reason. A grit sequence and finish schedule on a site-finished floor, so the number of cuts and the number of coats are a commitment rather than a discussion; cure times and return-to-service dates, so you know when the furniture can come back; and dust containment planned for a house nobody is going to open the windows in. Twenty-plus years of wood flooring has taught us that the arguments are almost never about the wood, they are about what nobody wrote down.
